Why Quartz Countertop Cutouts Need More Attention Before Fabrication

Why Quartz Countertop Cutouts Need More Attention Before Fabrication
Jun 24, 2026

Quartz countertops are often chosen because they look consistent, feel modern, and are easier to control than many natural stone surfaces. But in real projects, the most vulnerable part of a quartz countertop is not always the surface itself. It is often the opening: the sink cutout, hob cutout, faucet hole, drainage slot, or any area where the slab is interrupted before installation. For project buyers, contractors, cabinet makers, and distributors, quartz countertop cutouts deserve more attention before fabrication because they affect strength, support, transport safety, installation responsibility, and long-term performance.

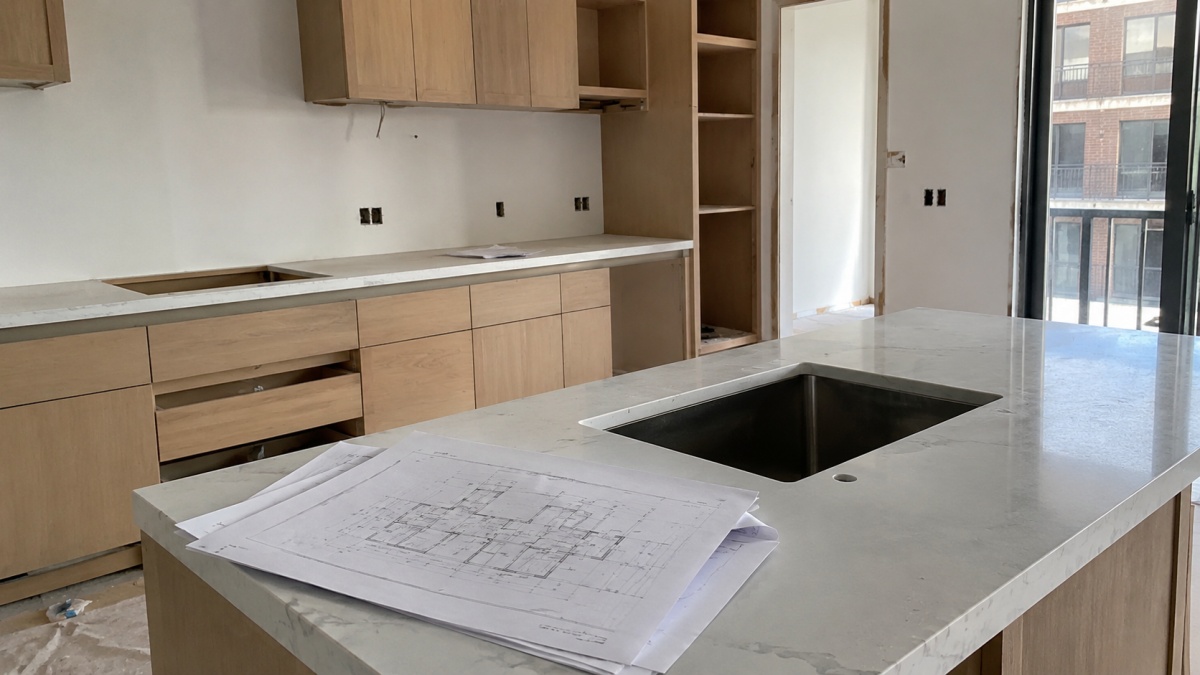

Quartz countertop fabrication drawings and material samples reviewed before production

The problem usually starts quietly. A buyer sends a countertop size. The factory confirms the drawing. The cabinet maker prepares the base. The installer expects the sink or hob to fit. Everyone assumes the cutout is “just a hole.” But a cutout changes the way stress moves through the countertop. It also reduces the strength around narrow strips, corners, edges, and appliance zones. When something goes wrong later, the question is rarely simple: was it a fabrication issue, a drawing issue, a cabinet support issue, a transport issue, or an installation issue?

A Quartz Cutout Is Not Just a Shape Removed From the Slab

Quartz is more predictable than many natural stones, but predictable does not mean risk-free. A full countertop panel has continuous material support across its length and width. Once an opening is cut, the remaining stone around that opening must carry more stress.

This is especially important around:

Sink openings
Hob or cooktop openings
Faucet holes
Undermount sink areas
Long narrow front rails
Back rails behind sinks
Cutouts close to seams
Cutouts near edges or corners
Large openings in thin countertop sections

The smaller the remaining stone strip, the more carefully it must be handled, packed, supported, and installed.

A quartz countertop does not usually fail because quartz is weak. It fails when design, drawing, support, handling, and installation do not respect the weak points created by the opening.

For buyers working on apartments, hotels, commercial kitchens, vanity tops, or contractor supply programs, early quartz project coordination is more valuable than late-site correction.

Sink Opening Support Matters More Than the Cut Itself

A sink opening may look simple on a drawing, but it is one of the most common places where responsibility becomes unclear.

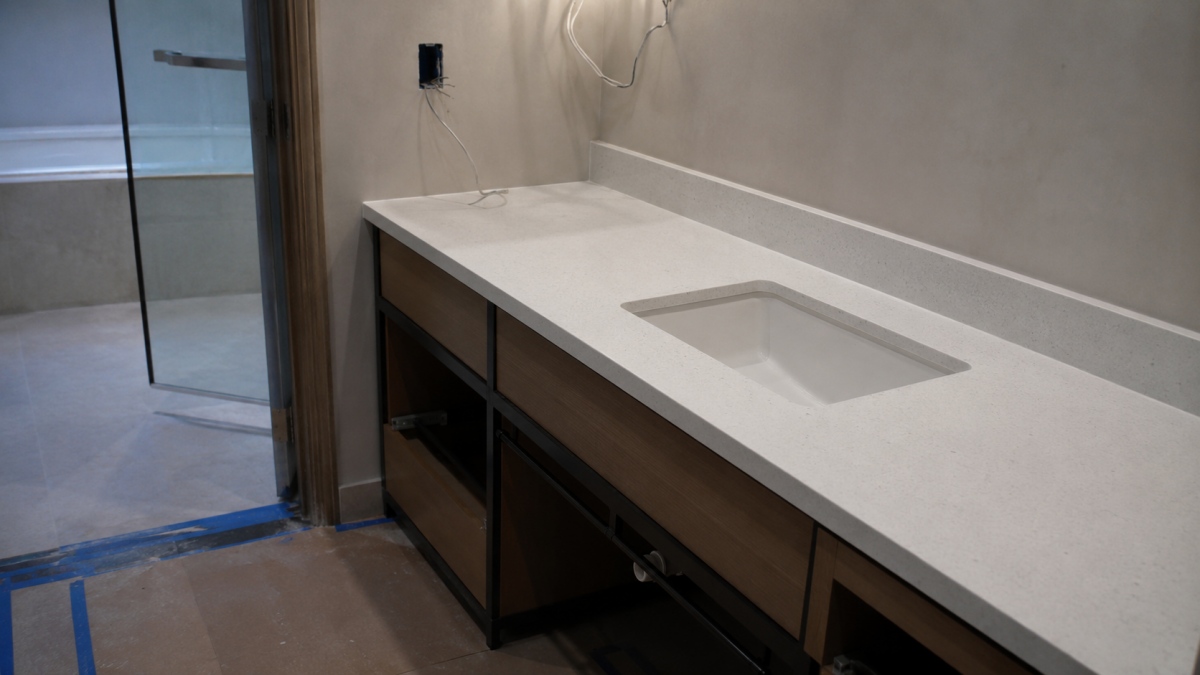

Quartz countertop sink opening with cabinet support reviewed before installation

A sink cutout affects several details at the same time:

The size of the opening
The sink installation type
The remaining front and back rail width
The distance from the opening to the countertop edge
The cabinet structure below
The sink weight when filled with water
The fixing method
The support system under the stone

An undermount sink is a good example. From the top, it may look clean and minimal. From the project side, it needs serious support. The sink should not depend only on the quartz surface to carry its full weight. The cabinet structure, brackets, rails, or other support methods must be planned before installation.

A beautiful sink opening without proper support is not a finished solution. It is an unfinished risk.

This is why sink opening support should be discussed before fabrication, not after the countertop arrives on site.

Hob and Cooktop Cutouts Add Heat, Movement, and Responsibility

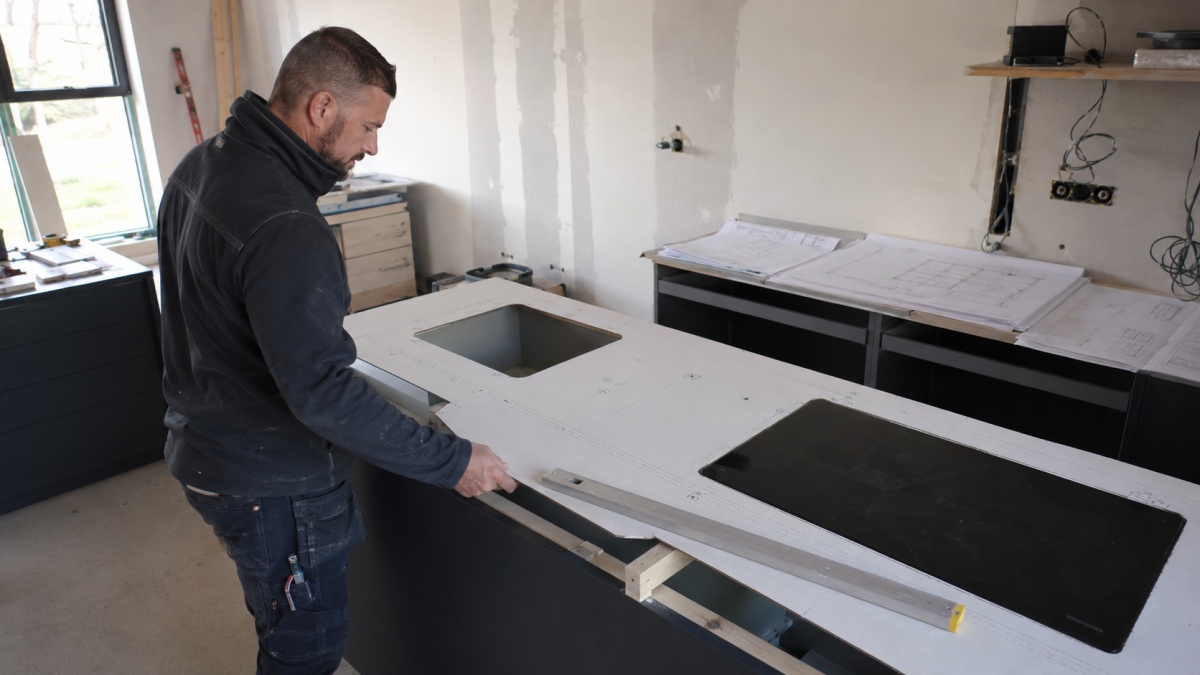

Quartz countertop hob cutout checked with appliance template before fabrication approval

A hob cutout risk is different from a sink cutout risk.

A sink opening mainly raises questions of support, water exposure, fixing, and weight. A hob or cooktop opening also brings heat, appliance clearance, expansion space, ventilation, and cabinet coordination into the discussion.

Project buyers should confirm:

Exact appliance model or template
Cutout size required by the appliance supplier
Minimum clearance around the hob
Distance from front edge and back wall
Cabinet ventilation requirements
Heat protection requirements
Support around the opening
Whether the hob sits flush, raised, or rebated
Whether the cutout is close to a seam or narrow strip

The stone supplier cannot safely guess appliance details from a general countertop drawing. The appliance supplier, cabinet maker, installer, and fabricator must work from the same information.

A hob cutout is where stone fabrication meets appliance engineering. Treating it as a normal rectangular opening is how avoidable site problems begin.

Inside Corners Should Not Be Treated Casually

Smooth inside radius detail on a quartz countertop cutout corner

One of the most important technical details in a countertop cutout is the inside corner.

Sharp inside corners create stress concentration. In simple language, stress tends to gather around tight internal corners, especially during handling, transport, installation, thermal movement, or load pressure. A proper corner radius helps reduce this risk.

This matters for:

Sink cutouts
Hob cutouts
Square internal corners
Drainage grooves near openings
Openings close to edges
Long countertop pieces with several cutouts

From a buyer’s point of view, the key question is not only “Can you cut this shape?” The better question is:

“Is this cutout shape safe for fabrication, transport, and installation?”

If the design requires sharp-looking corners, the drawing should still be reviewed carefully to avoid creating a hidden weak point. The visible design and the fabrication logic must not fight each other.

Faucet Holes and Small Holes Also Need Spacing Logic

Small holes are easy to underestimate.

A faucet hole, soap dispenser hole, filtered water tap hole, or accessory hole may seem harmless compared with a large sink opening. But holes placed too close to each other, too close to the sink cutout, or too close to the back edge can weaken the remaining quartz area.

Project buyers should confirm:

Hole diameter
Center position
Distance between holes
Distance from hole to sink opening
Distance from hole to back edge
Whether holes conflict with cabinet or wall details
Whether the faucet base covers the hole properly
Whether the installer will drill on site or the factory will pre-cut

Factory drilling may improve accuracy when drawings are reliable. Site drilling may allow flexibility when site conditions are uncertain. Neither option is automatically better. The right choice depends on project control.

This is why a quartz fabrication drawing must include hole positions clearly, not only countertop length and width.

Fabrication Drawings Must Include More Than Countertop Dimensions

A countertop drawing should not be treated as a decoration. It is a technical agreement between buyer, supplier, fabricator, installer, cabinet maker, and sometimes the appliance supplier.

A useful quartz fabrication drawing should show:

Finished countertop dimensions
Thickness
Surface finish if relevant
Edge profile
Visible edges
Sink cutout size
Sink type
Hob or cooktop cutout size
Faucet hole position
Backsplash or side splash details
Seam position
Overhang
Cabinet support zones
Wall condition if already known
Piece numbering
Packing sequence if multiple rooms are involved

A drawing that only shows the outside size of the countertop does not control the project. It only controls the rectangle.

For buyers comparing multiple project materials or countertop supply options, the drawing stage is also where quotation differences become clearer. One supplier may include cutouts, edge polishing, packing protection, and pre-shipment checks. Another may quote only basic fabrication. The unit price may look similar, but the actual scope is not the same.

Countertop Edge Protection Becomes More Important After Cutouts

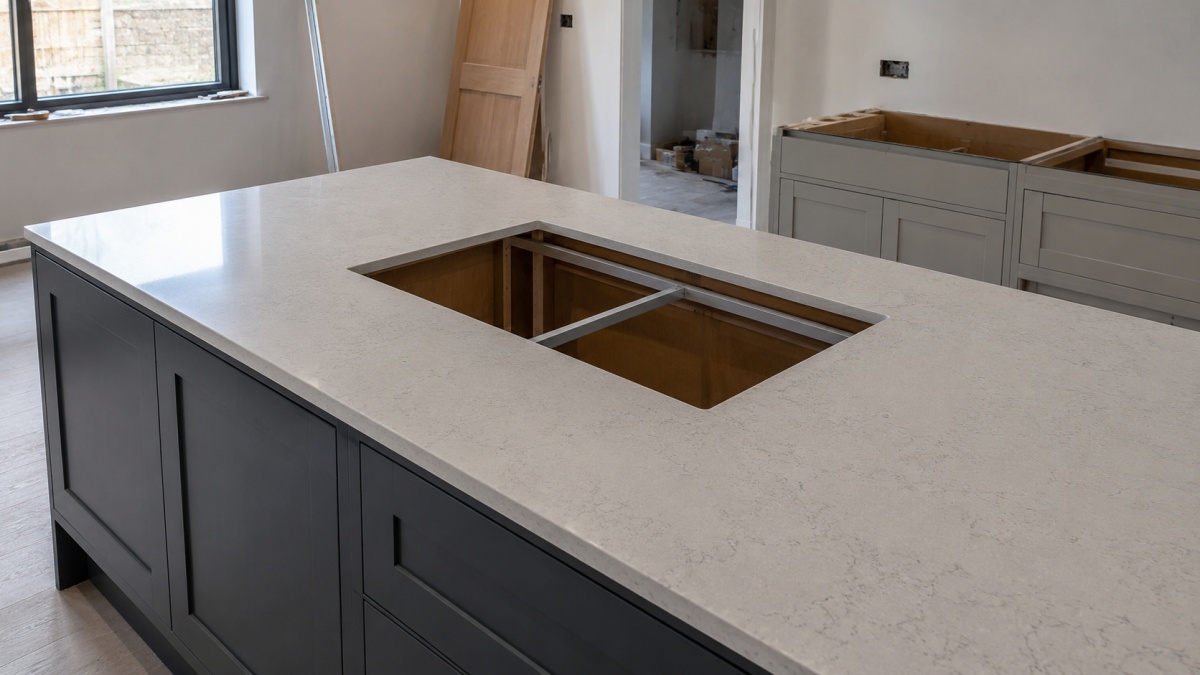

Quartz countertops with sink cutouts protected before export packing

A full quartz slab or simple rectangular top is easier to handle than a countertop with openings. Once the sink or hob area is cut, the remaining narrow rails around the opening become more vulnerable during lifting, packing, container loading, unloading, and site movement.

This is why countertop edge protection should be planned around the weakest parts, not only the outer edges.

Protection should consider:

Front rail near sink opening
Back rail behind hob cutout
Thin strips around faucet holes
Corners of cutouts
Mitered or polished visible edges
Long narrow pieces
Countertops packed vertically
Pieces with multiple cutouts
Export movement and vibration

The purpose of packing is not only to make the goods look organized. It is to keep the most fragile details alive until installation.

For export projects, this point matters even more. A countertop may pass factory inspection but fail later if it is lifted from the wrong point, packed without enough separation, or handled as if it were a solid rectangular slab.

Installation Responsibility Should Be Clarified Early

Quartz countertop cutouts often sit at the intersection of several responsibilities.

The stone supplier may fabricate the countertop.
The cabinet maker may provide the base.
The appliance supplier may provide the hob template.
The sink supplier may define the mounting method.
The installer may adjust details on site.
The buyer may be responsible for final approval.

If responsibilities are not clearly defined, the cutout becomes a blame point.

Before production, the project team should clarify:

Who provides the final sink template?
Who confirms the hob model?
Who checks cabinet support?
Who confirms cutout position?
Who is responsible for site measurement?
Who approves fabrication drawings?
Who handles on-site adjustment?
Who checks if the sink has independent support?
Who confirms if cutouts can be made in the factory or on site?

Good project coordination does not remove all risk. It removes the easiest misunderstandings.

For buyers who want to understand broader stone project planning, countertop cutouts are a useful example of how one small detail can affect the whole delivery chain.

Common Mistakes Buyers Should Avoid

The first mistake is approving countertop size without confirming sink and hob details. A countertop is not ready for fabrication if the appliance information is missing.

The second mistake is assuming all sinks need the same opening logic. Top-mount, undermount, flush-mount, and integrated sinks require different planning.

The third mistake is placing cutouts too close to edges, seams, or other openings without asking whether the remaining quartz area is safe.

The fourth mistake is ignoring cabinet support. A cutout can be accurate and still perform badly if the base below is weak or incomplete.

The fifth mistake is choosing the lowest fabrication quotation without checking whether edge finishing, cutout polishing, packing protection, and photo inspection are included.

The sixth mistake is leaving faucet holes or accessory holes for late-stage guessing. Small holes can create large problems when they conflict with walls, sinks, cabinets, or fittings.

The seventh mistake is treating packing as a warehouse issue. For cutout countertops, packing is part of the risk-control system.

A Practical Checklist Before Approving Quartz Countertop Cutouts

Before fabrication starts, buyers should confirm the following:

Final site measurement
Approved countertop drawing
Quartz color and thickness
Finished edge profile
Sink model and installation type
Sink cutout size
Sink support method
Hob or cooktop model
Hob cutout size and clearance
Faucet hole positions
Distance from holes to openings and edges
Seam position
Overhang and cabinet support
Corner radius requirement
Cutout polishing requirement
Whether factory cutout or site cutout is preferred
Packing protection for cutout areas
Pre-shipment photos
Responsibility for installation adjustment

This checklist is not paperwork for paperwork’s sake. It is a way to keep fabrication, packing, and installation aligned before the quartz is cut.

When Should Cutouts Be Made in the Factory?

Factory cutouts are usually suitable when drawings, templates, site measurements, and appliance information are reliable. They can improve consistency, reduce on-site dust, and give the buyer a clearer pre-shipment inspection record.

However, factory cutouts may not be ideal when:

Site dimensions are uncertain
Cabinet positions may change
Appliance models are not finalized
Wall conditions are irregular
The installer wants final adjustment on site
Transport risk is high for a fragile narrow section

There is no single rule that fits every project. The better decision is based on site certainty, drawing quality, appliance confirmation, and handling risk.

A responsible supplier should not simply push all cutouts to the factory or all cutouts to the installer. The right choice depends on the project.

What Buyers Should Ask the Supplier

Before confirming a quartz countertop order, buyers can ask direct questions:

Do the drawings show all cutouts and holes?
Are the sink and hob models confirmed?
Is the remaining front rail wide enough?
Are inside corners designed safely?
Is sink support handled by the cabinet or installer?
Are faucet holes placed far enough from the sink opening and back edge?
Will the cutout edges be polished or only cut?
How will the countertop be protected during packing?
Can you provide photos before shipment?
Who is responsible if site dimensions change after production?

The answers do not need to be complicated. They need to be clear.

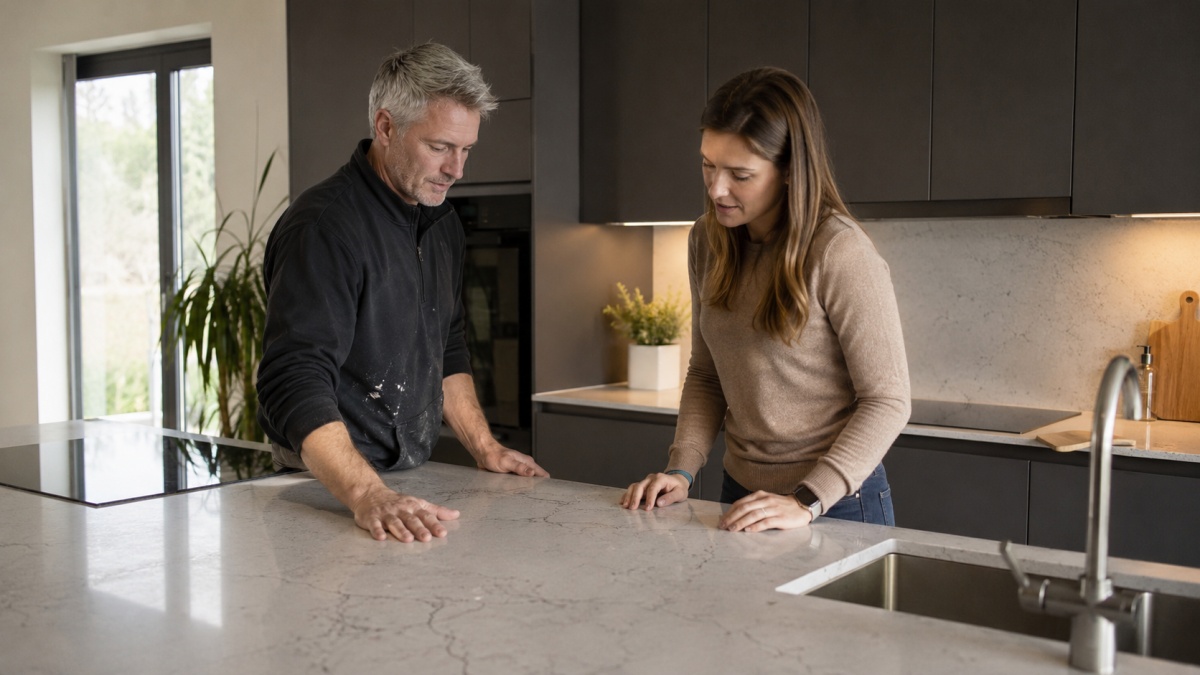

Quality control inspection of a quartz countertop cutout before shipment

FAQ

Why do quartz countertop cutouts need extra attention?

Quartz countertop cutouts interrupt the continuous structure of the slab. Openings for sinks, hobs, faucets, or accessories create narrow areas where stress, handling damage, support problems, or installation mistakes are more likely to appear.

Are quartz countertops weak around sink openings?

Quartz countertops are generally strong, but sink openings reduce the amount of material around the cutout. The area becomes more sensitive to support, handling, corner radius, and installation method, especially for undermount sinks or large openings.

What is sink opening support?

Sink opening support refers to the cabinet, bracket, rail, or other support system that carries the sink and helps protect the quartz around the opening. The sink should not rely only on the countertop surface for support, especially when it is heavy or filled with water.

Why is a hob cutout different from a sink cutout?

A hob or cooktop cutout involves heat, appliance clearance, ventilation, and expansion space. The cutout must follow the appliance template and should be coordinated with the cabinet maker and installer before fabrication.

Should faucet holes be drilled in the factory or on site?

Both options can work. Factory drilling is better when drawings and site measurements are confirmed. Site drilling may be safer when wall conditions, cabinet positions, or fitting details are uncertain. The decision should be made before production.

What should a quartz fabrication drawing include?

A quartz fabrication drawing should include finished size, thickness, edge profile, visible edges, sink and hob cutout sizes, faucet hole positions, seam locations, overhang, backsplash details, support zones, and piece numbering when needed.

How can buyers reduce countertop cutout risk?

Buyers can reduce risk by confirming appliance templates, sink type, cutout dimensions, support method, hole positions, corner radius, packing protection, pre-shipment photos, and responsibility boundaries before fabrication starts.

Before You Approve Fabrication

Quartz countertops are often sold as clean, modern, and reliable. That is true when the project details are controlled. But cutouts are where the simple countertop becomes a technical object.

The best time to solve a cutout problem is before the quartz is cut.

For project buyers, contractors, and distributors, a clear conversation about drawings, openings, support, protection, and installation responsibility can prevent expensive disputes later. If your next project includes quartz countertops with sinks, hobs, or multiple drilled holes, review the cutout details before approving fabrication.

Aoli Stone supports quartz countertop and project stone supply for commercial, hospitality, residential, and contractor projects. If your order involves custom drawings, sink openings, hob cutouts, or export packing requirements, you can share the project details for a technical review before production.
